Northeast Hospital Expansion 123 Medical Lane, USA |
|||||||||||||||||||||||||||||||||||||||||||||||||
Building Statistics Part 1
Architecture: The Northeast Hospital Expansion includes the construction of a new ten story patient tower, central utility plant and a four-level parking garage. The patient tower allows for 180 new private patient rooms. Patient floors include floors one through six, each floor houses 30 patient rooms with the sixth floor reserved for future growth. Mechanical equipment occupies the basement and floors seven through ten. The ground floor allocates space for the linen storage, biowaste room, autopsy room, body holding room, and electrical equipment. A connection bridge on the ground floor lets occupants transverse between the new patient tower and the rest of the hospital campus. The design also allows for deliveries and vehicular traffic The exterior of the patient tower curves to maximize use of the land and the entire structure wears a glimmering blue curtain wall at patient occupied floors and metallic louvers enclose the top four floors of mechanical space. Major National Codes Utilized:

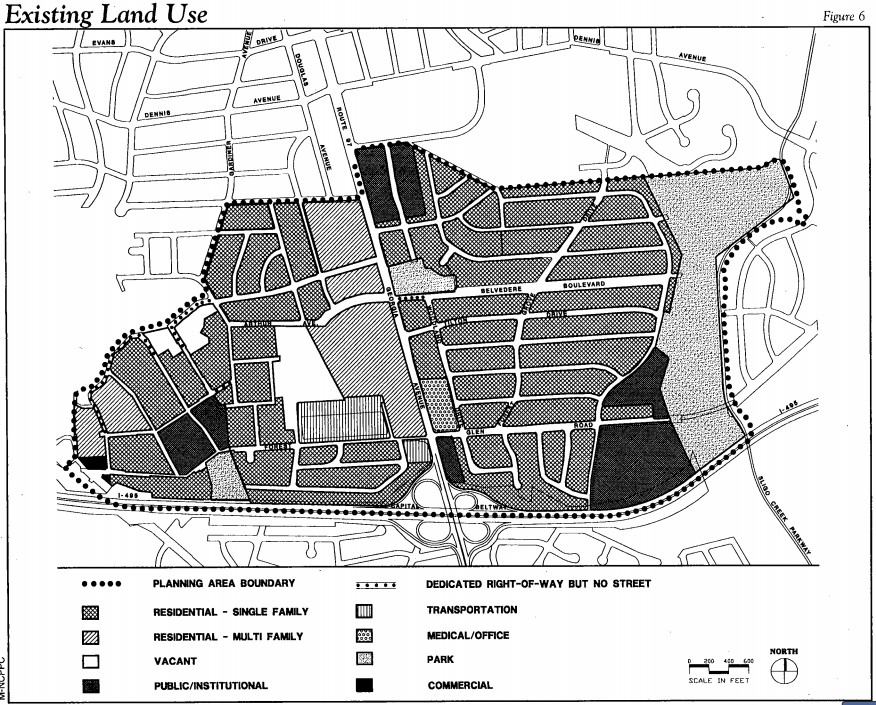

Zoning: Zoning map courtesy of the local planning board
Build Façade: Roofing: Three different types of roofing enclose the roof of the Northeast Hospital Expansion. The portions of the patient tower’s roof used for the walkway toward the mechanical roof top units uses built-up asphalt with a vapor barrier and 3” of tapered insulation sloped at ¼” per foot towards the roof drains. The rest of the patient tower roof is covered in a green roof made from growing media, filter fabric drainage board, 3 ply cold applied roofing system, sheathing, 3” of rigid insulation and a vapor barrier. Finally portions of the existing hospital space undergoing renovations receive another green roof system. The renovation green roof includes growing media, filter fabric drainage board, fleece back TPA Root Barrier set in water based adhesive, single ply trilaminate water proofing felt set in solvent free adhesive, 5/8” DensDeck set in green biobased foam insulation adhesive, quick dry primer, and then the existing three ply of built-up roof system. Sustainability:
Building Statistics Part 2 Construction: The Northeast Hospital Expansion project received its notice to proceed on January 8th, 2013 and expects to undergo construction until complete for occupancy move in on the sixth floor September 6th, 2015. In the projects entirety, a total duration of 733 days need to occur. The first phase of the project is the excavation in which there will be an assembly line of dump trucks circling the hospital to haul dirt. The second is the construction of the superstructure. Here there will be a tower crane constructed and a material hoist to lift material to the guys working on the upper floors. The final phase change will occur when the building becomes fully enclosed and the lay down areas move to their specific floors within the structure.Work flows in a zigzag pattern from north to south movingfrom the west to the east starting at the ground floor and moving up. At this point in time there is no longer a need for the tower crane since the building is fully enclosed and all of the heavy lifts havebeen completed. The material hoist has also been dismantled since the elevators in the building are now operational.

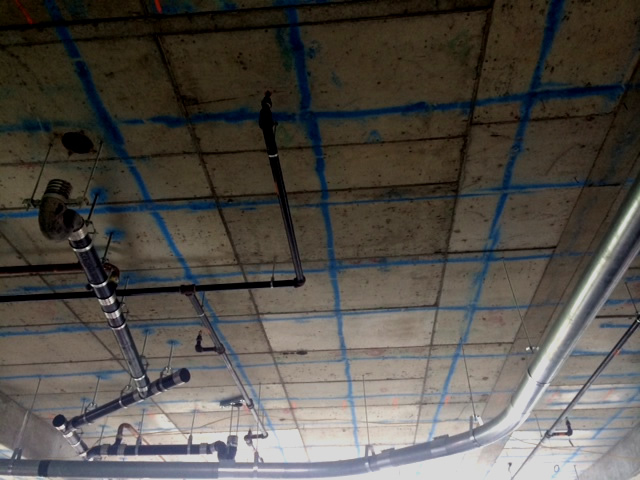

Structure: The superstructure is composed primarily of reinforced concrete columns supporting 10 1/2" thick slabs. All of the concrete slabs above the ground floor are post tensioned. To avoid drilling through the tensioned tendons the post tensioned slabs have been painted with the tendon locations. The concrete columns have a concrete strength of 4000psi and the slabs have a concrete strength of 3500psi. In total there will be 4026 CY of concrete, 1065.3 tons of reinforcement, and 12 tons of post-tensioning tendons. Once the structure reaches the mechanical penthouse levels, the struccture switches from concrete to hollow structural steel tubing.

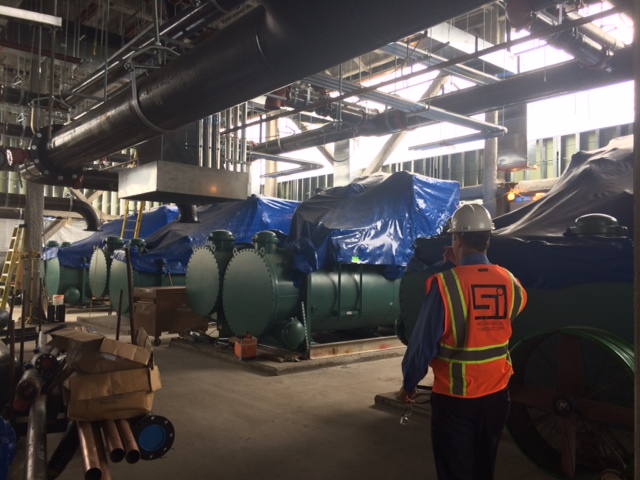

Mechanical: The building is heated and cooled by a typical boiler and chiller system located in themechanical penthouse. The chill water lines and hot water lines run out to fan coil units and radiant fin terminal units located through out the patient tower. High pressure steam and medium pressure steam are supplied to the rest of the campus by being piped from the mechanical penthouse down to the basement of the patient tower and through utility tunnels located to the north wall of the patient tower. Medical gas, nitrogen, oxygen, and carbon dioxide are also supplied to each patient room. The majority of AHU’s are located in the mechanical penthouse with the exception of the autopsyunit. The autopsy unit is located in the basement and requires pre-filters and HEPA filters. The air supplied to theautopsy rooms is then 100% exhaust.

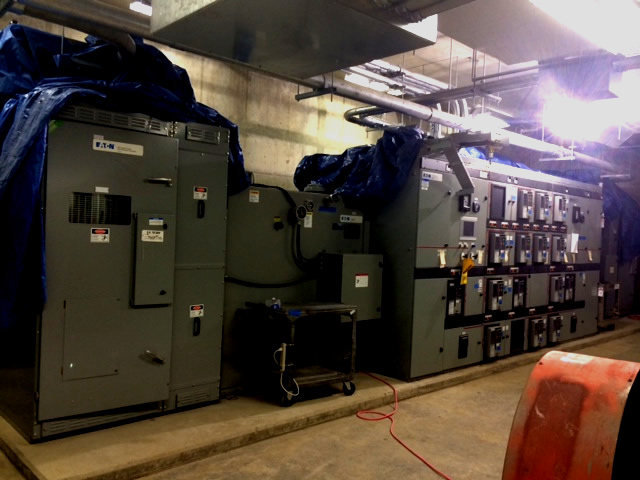

Electrical: Electrical distribution is accomplished by a 13.2kVA, 12000A, 750MVA, 3 phase, primary incoming utility switchgear located in the basement. The power is then stepped down to a 480/277V and distributed to three substations of 25000kVA, 480/277V and one substation of 2000kVA, 480/277V for the chillers in the pent house. From the substation electricity is distributed by separate lines to independent transformers at each piece of equipment or directly to the panels located on each floor. There are three 2000kW generators with an emergency switchgear to be utilized for critical zones within the hospital in the event of a power outage to the campus. Lighting is accomplished by basic fluorescent tube lighting with occupancy controls.
|
|||||||||||||||||||||||||||||||||||||||||||||||||
